Water Treatment Update

Jackie Fidecaro continues to maintain communication with Kitsap PUD regarding our water treatment update.

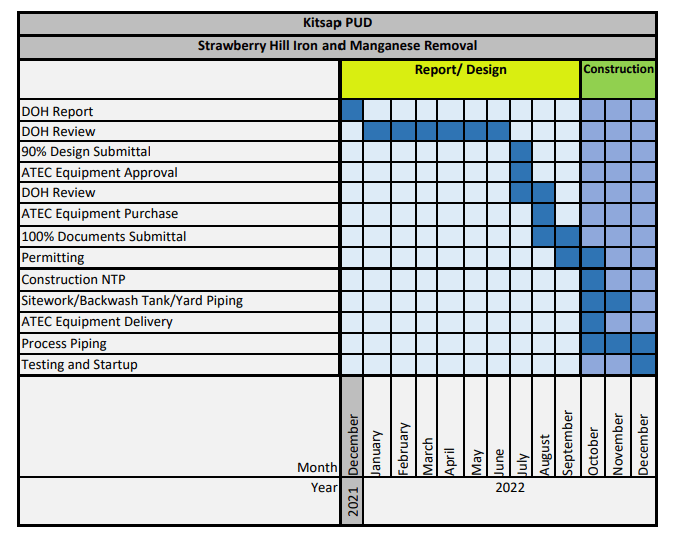

Below is an updated project schedule.  There have been some delays in the design phase but we are still on track to complete construction this year.  The schedule shows beginning the Construction phase in October but the construction director believes we will actually start that work in September.

Updates on specific items:

  • DOH has commented on the report and our Engineer (Murray Smith & Assoc.) is reviewing
  • Control/Pump Supplier has delivered PLC/VFD Conversion (at our shop)
  • ATEC Filters are in production (delivery expected late July/early August)
  • Construction/Start-Up Q4 2022
